Time Study and Work Measurement in Operations Management
Time study and work measurement explained: steps, rating, allowances, normal and standard time formulas, a fully worked carton-packing example, and work sampling with sample size.
Updated 11 min read
Work measurement is the application of techniques designed to establish the time for a qualified worker to carry out a specified job at a defined level of performance. Time study is its best-known technique: an analyst observes a job, breaks it into elements, times each element over several cycles, adjusts for the worker's pace and adds allowances to arrive at a standard time.
Without time standards, management works on guesswork. It cannot say how long a job should take, whether a slow result is due to the worker or the method, how many people a plan needs, or what a fair incentive target is. With a measured standard, a supervisor can say "this carton should take about 1.12 minutes" instead of "do it quickly", and planning, costing and wage decisions rest on evidence.
Objectives and uses of work measurement
The main objective is to determine the standard time for a job under normal conditions. That single figure answers several management questions: how long the job should take, how many workers are needed, how much output to expect and how to schedule the work.
Uses of standard time
production planning, scheduling and delivery promises
manpower planning and capacity planning
line balancing on assembly lines
labour costing, estimating and pricing
wage incentive schemes and fair output targets
comparing the productivity of workers, shifts and alternative methods
revealing idle time, delays and underused equipment
What goes wrong without it
Schedules become unreliable, labour plans inaccurate, targets unrealistic, incentives unfair, machine loading difficult and cost estimates poor.
Work measurement and time study compared
Work measurement is the broad field; time study is one technique inside it. The objective of time study is to find the time an average (qualified) worker needs under normal conditions, neither an unusually slow nor an unusually fast one.
Technique
Method
Best suited to
Stopwatch time study
Direct timing of elements over several cycles, with rating and allowances
Short, repetitive jobs
Work sampling
Random instantaneous observations give the proportion of time in each activity
Long, irregular or group work; utilisation studies
Standard data
Previously measured element times are combined for new jobs
Families of similar jobs
Predetermined motion time systems (PMTS), such as Methods-Time Measurement (MTM)
Published times for basic motions (reach, grasp, move) are added up
Jobs being designed; very short cycles
Analytical estimating
An experienced estimator builds times from past data and judgement
Non-repetitive maintenance or construction work
Because a time standard is only as good as the method it measures, method study should come first; time study then sets the time for the improved method.
Equipment for time study
Stopwatch: traditionally a decimal-minute watch reading to 0.01 minute; today often a digital timer or a tablet app.
Time study board: a clipboard that holds the watch and the form so the analyst can read and write together.
Time study (observation) sheet: a form listing the elements down the side and the cycles across the top.
Calculator or computer for the analysis, and sometimes a video camera for detailed or micromotion study.
Instruments unrelated to timing, such as a thermometer, are not part of time study equipment.
Steps in a stopwatch time study
1. Select the job and the worker
Choose a job where a standard is needed: output is important, time is uncertain, delays are common or cost is high. Choose a qualified, experienced worker who works at a steady pace, and explain the purpose of the study to the worker and the supervisor.
2. Record and standardise the method
Write down the method, tools, materials, layout and working conditions. Timing should only begin once the method is proper and settled.
3. Break the job into elements
An element is a distinct part of the job with clear start and end points (break points). For carton packing the elements could be: fold carton, place items, seal, label. Elements make observation easier, separate machine-controlled from worker-controlled parts, show where the time goes and allow element times to be reused as standard data.
4. Time the elements over several cycles
With the continuous (cumulative) method the watch runs throughout and readings are subtracted afterwards; with the snap-back (flyback) method the watch is reset to zero after every element. Several cycles are timed, and abnormal readings caused by unusual events, such as a dropped tool, are excluded from the average.
5. Decide the number of cycles
More cycles give more confidence. A common formula for the number of observations, for 95 per cent confidence and an accuracy of plus or minus 5 per cent, is
n=∑x40N∑x2−(∑x)22
where N is the number of pilot readings and x is each reading. Alternatively, with a pilot standard deviation s and mean xˉ, n=(axˉzs)2, where z is the confidence factor and a the accuracy as a fraction.
6. Rate the worker's performance
The analyst compares the observed pace with a defined normal pace (100 per cent). A worker judged 10 per cent faster than normal is rated 110; one 10 per cent slower is rated 90. Rating turns the observed time into the time a normal worker would take. Common systems include pace (speed) rating and the Westinghouse levelling system, which considers skill, effort, conditions and consistency.
7. Add allowances and set the standard
No one can work continuously like a machine, so allowances are added to normal time.
Personal allowance: for personal needs such as drinking water or using the washroom.
Fatigue (relaxation) allowance: for recovery from physical and mental effort; it rises with heavy work, heat, noise or monotony.
Process (unavoidable delay) allowance: compensates for machine waiting or process delays outside the worker's control.
Contingency, policy or special allowances: for small, irregular extra work, or set by management policy.
Personal and fatigue allowances together are often called PF allowances, and a combined total of about 10 to 20 per cent is common in textbook problems.
The formulas
Observed time (OT)=number of cycles∑readings
Normal time (NT)=OT×100Rating
Standard time (ST)=NT×(1+A)
Here A is the allowance expressed as a fraction of normal time. When allowances are instead given as a fraction of the total working day, the formula becomes ST=1−ANT. Read the question carefully to see which basis is intended.
Term
Meaning
Observed (actual) time
What the analyst actually saw on the watch
Normal (basic) time
Observed time adjusted to a normal pace by rating
Standard (allowed) time
Normal time plus allowances; the figure used for planning and pay
Worked example: standard time for carton packing
Suppose a packing unit (hypothetical figures) times a packer over five cycles. Readings are in minutes. Allowances are 15 per cent of normal time, and the wage is ₹180 per hour.
Element
Cycle 1
Cycle 2
Cycle 3
Cycle 4
Cycle 5
Total
Rating
A Fold carton
0.20
0.22
0.19
0.21
0.18
1.00
110%
B Place items
0.35
0.33
0.36
0.34
0.37
1.75
100%
C Seal
0.25
0.27
0.24
0.26
0.23
1.25
90%
D Label
0.15
0.16
0.14
0.15
0.15
0.75
120%
Step 1: observed (average) time for each element.
Step 3: total observed and normal time per carton.
∑OT=0.200+0.350+0.250+0.150=0.950 min
∑NT=0.220+0.350+0.225+0.180=0.975 min
Rating has added 0.975−0.950=0.025 minute.
Step 4: standard time.

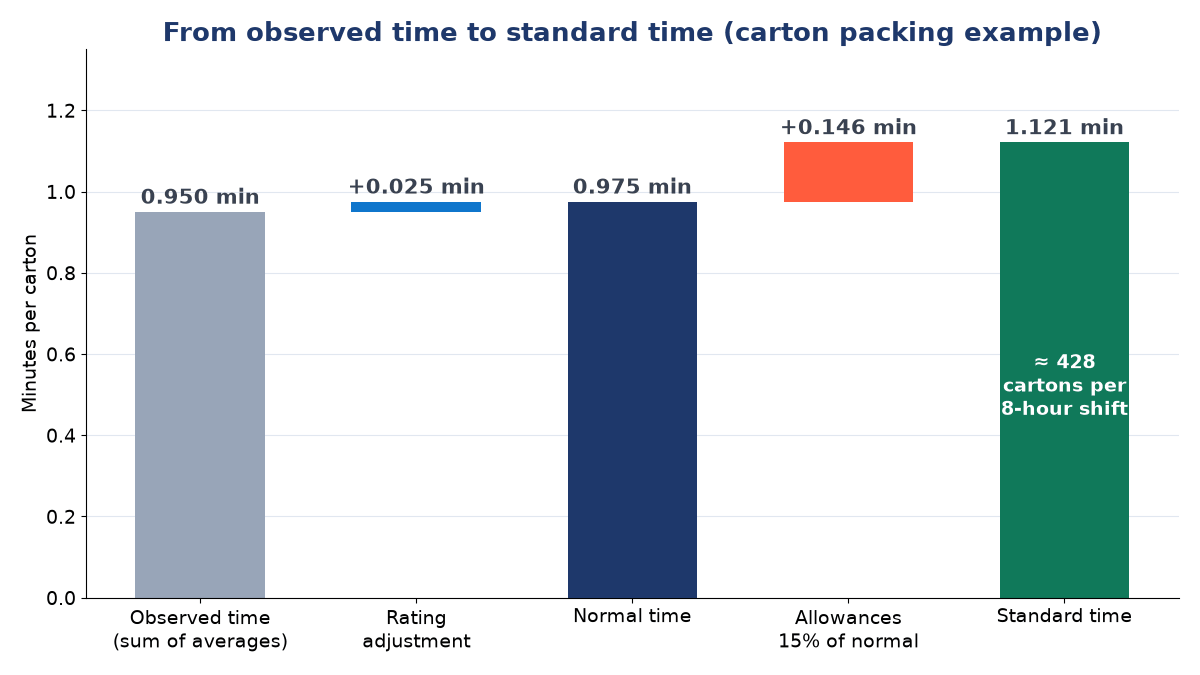

ST=0.975×1.15=1.12125≈1.121 min per carton
The allowances add 0.975×0.15=0.14625≈0.146 minute.
Step 5: standard output per 8-hour shift.
1.121258×60=1.12125480=428.1≈428 cartons
Step 6: standard labour cost per carton. At ₹180 per hour, labour costs 60180=3 rupees per minute, so the standard labour cost is 1.12125×3=3.36 rupees, or about ₹3.36 per carton.
If the allowance had been stated as 15 per cent of the working day instead, the standard time would be 1−0.150.975=1.147 minutes, which shows why the basis matters.

Element times in the carton example: rating raises fast workers' times and lowers slow workers' times before allowances are added.How the standard time of 1.121 minutes is built up from the observed time.
Work sampling
Work sampling (activity sampling), developed by L. H. C. Tippett in the British textile industry, estimates the proportion of time spent on different activities from a large number of random, instantaneous observations. At each random moment the observer simply notes whether the worker is working or waiting, or whether the machine is running or idle.
Worked example: machine utilisation
Suppose an observer makes 400 random observations of a packing machine over two weeks and finds it running in 340 of them.
p^=400340=0.85
The machine is estimated to be running 85 per cent of the time and idle 15 per cent. In a 480-minute shift that means about 0.15×480=72 idle minutes. To be 95 per cent confident that the estimate is within plus or minus 3 percentage points (e=0.03, z=1.96), the number of observations needed is
so at least 545 observations are required; the 400 already taken are not enough for that accuracy.
Basis
Time study
Work sampling
Observation
Continuous timing of a job
Random, instantaneous snapshots
Result
Standard time per cycle
Share of time in each activity
Suited to
Short, repetitive cycles
Long, varied or group work
Effect on the worker
Worker knows they are being watched closely
Less intrusive
Cost
Needs a trained analyst for long periods
Cheaper; observers need less training
Applications
Manufacturing
Packing, machining, assembly (for example, the time to assemble one switchboard unit), inspection, loading and unloading, and other repetitive operations.
Services
Patient registration in a hospital, processing a bank form, billing at a store counter, handling files in an office, order picking in a warehouse and admission work in a school.
Work measurement, incentives and productivity
Incentive schemes need a fair definition of expected output. If the standard for a carton is 1.121 minutes, a worker producing more than 428 cartons in a shift has beaten the standard and can be paid a bonus. Without measured standards, incentive schemes are arbitrary and often disputed. Measured time also improves productivity because it reveals delays, supports better scheduling, exposes underused capacity and helps balance work across stations and staff.
Benefits and problems
Benefits
Problems
Better planning and scheduling
Workers may resist close observation
Control: actual performance compared with standard
If a poor method is timed, the standard is poor too
Shows where time is lost
Careless timing gives unreliable results
Better labour utilisation
Workers may change pace while being observed
Accurate labour cost estimates
Performance rating depends on the analyst's judgement
Fair incentive schemes
Standards date quickly when methods change
Conditions for a successful study
the method is improved and fixed before timing
the worker understands the purpose
the analyst is trained and impartial
enough cycles are observed
allowances are fair and clearly stated
management uses the results for improvement, not harassment
Key terms
Work measurement
Techniques for establishing the time for a qualified worker to do a specified job at a defined level of performance.
Time study
Timing and rating the elements of a job to establish its standard time.
Element
A distinct part of a job with clear break points, timed separately.
Observed time
The average of the valid stopwatch readings for an element or job.
Performance rating
The analyst's assessment of the worker's pace against normal pace, as a percentage.
Normal time
Observed time multiplied by the rating factor.
Allowances
Extra time for personal needs, fatigue and unavoidable delays.
Standard time
Normal time plus allowances; the time allowed for the job.
Work sampling
Estimating the share of time in each activity from random instantaneous observations.
PMTS
Predetermined motion time systems, which build job times from published times for basic motions.
Common questions
What is the difference between normal time and standard time?
Normal time is the observed time adjusted to a normal pace by rating. Standard time is normal time plus allowances for personal needs, fatigue and delays. In the example, normal time is 0.975 minute and standard time is 1.121 minutes.
Why is performance rating necessary?
Observed workers do not all work at the normal pace. Without rating, timing a fast worker would give a standard that is too tight and timing a slow worker one that is too loose.
Are allowances added to observed time or normal time?
To normal time. Rating is applied first, then allowances. Check whether the allowance is a percentage of normal time, ST=NT(1+A), or of the working day, ST=1−ANT.
What does the process allowance cover?
It compensates the worker for machine waiting or process delays that are outside the worker's control.
When is work sampling preferred to time study?
When jobs are long, irregular or spread across many people or machines, or when the question is how much time is idle or productive rather than how long one cycle takes.
Why should method study come before time study?
Timing a wasteful method builds the waste into the standard. The method is improved first, and then its time is measured.
References
Kanawaty, G. (ed.) Introduction to Work Study. International Labour Office, Geneva.
Taylor, F. W. (1911) The Principles of Scientific Management. Harper & Brothers.
Stevenson, W. J. Operations Management. McGraw-Hill Education.
Chase, R. B. and Jacobs, F. R. Operations and Supply Chain Management. McGraw-Hill Education.
Panneerselvam, R. Production and Operations Management. PHI Learning.
