Production scheduling explained: types, objectives and factors, with worked FCFS, SPT, EDD, critical ratio and Johnson's rule examples and a Gantt chart.
Updated 11 min read
Production scheduling is the process of fixing the time and order in which production activities will be carried out. It decides when each job or operation should start and finish, which machine or worker will do it, and in what sequence jobs will be taken up, so that orders are completed on time with the least delay and waste.
In simple words, scheduling is the timetable of the shop floor. A plan may say that 5,000 units must be made this month; the schedule says which job runs on which machine on Monday at 10 AM. Without it, machines sit idle while others are overloaded, urgent orders are missed and costs rise. That is why scheduling is treated as a key part of production planning and control.
Take a printing press that has received three orders: wedding cards, school notebooks and business flyers. The manager must decide which order goes first, which machine prints what, when binding starts, when packing starts and which order must be delivered first. Getting this right means every order leaves on time using the same machines and staff. Getting it wrong means rush work, overtime and unhappy customers. The whole time-based arrangement is production scheduling.
Good scheduling:
ensures timely delivery and better customer service;
improves machine and labour utilisation;
reduces idle time, waiting and congestion;
lowers work-in-progress inventory and overtime cost;
gives managers a clear standard to compare actual progress against.
Planning, routing, sequencing, scheduling and dispatching#
These terms appear together in production planning and control, and students often confuse them.
Term
Question it answers
Example
Planning
What and how much should be produced?
Make 5,000 notebooks this month
Routing
Through which operations and machines will the work pass?
Printing, then binding, then packing
Sequencing
In what order will waiting jobs be processed?
Flyers before notebooks on the press
Scheduling
When will each operation start and finish?
Flyers print from 9 AM to 11 AM on Monday
Dispatching
Who is authorised to start the work now?
A job order issued to the press operator at 9 AM
Planning is broader and looks further ahead; scheduling converts the plan into a detailed time table. Scheduling prepares the timetable, and dispatching puts it into action by releasing orders, materials and instructions.
The master production schedule (MPS) states which end products will be made, in what quantity and in which week. It links the aggregate plan with detailed shop-floor schedules and material requirements planning.
Work is scheduled from today onward, placing each operation as early as possible. It tells the manager the earliest possible completion date. It is common in job shops where orders must be done as soon as possible, but it can build up inventory if work finishes well before the due date.
Work is scheduled backwards from the due date, placing each operation as late as possible while still finishing on time. It keeps inventory low and is used in assembly and MRP systems, but it leaves little slack for disruptions.
Before sequencing, jobs are assigned to work centres, which is called loading. Infinite loading assigns work without regard to capacity and then shows the overloads; finite loading never lets the load exceed capacity. Loading is often displayed on a load chart, a type of Gantt chart.
Scheduling in different production systems#
System
Nature of scheduling
Main difficulty
Job production
Each order is unique and scheduled separately, operation by operation
Many routes and competing priorities
Batch production
Batches are scheduled in turn on shared machines
Set-up changes between batches and batch sizes
Mass production
The line runs at a fixed rate; scheduling sets the output rate and shift plan
Keeping materials flowing and avoiding line stoppages
When several jobs are waiting at one machine, a priority rule decides the order. The commonly used rules are:
First Come, First Served (FCFS) – jobs are done in order of arrival. Simple and seen as fair, but urgent or short jobs may wait behind long ones.
Shortest Processing Time (SPT) – the shortest job goes first. It minimises average flow time and average number of jobs in the system, but long jobs may keep waiting.
Earliest Due Date (EDD) – the job due soonest goes first. It tends to reduce lateness, though short, easy jobs may be delayed.
Longest Processing Time (LPT) – the longest job goes first; used occasionally when big jobs must be started early.
Critical Ratio (CR) – compares time remaining with work remaining.
The measures used to compare rules are:
Average flow time=Number of jobsSum of completion times
Tardiness of a job=max(0,Completion time−Due date)
Average jobs in system=Total processing timeSum of completion times
Suppose a print shop has five jobs waiting at one machine at the start of day 0, listed in order of arrival.
Job
Processing time (days)
Due date (day)
A
6
8
B
2
6
C
8
18
D
3
15
E
9
23
Total processing time is 6+2+8+3+9=28 days.
FCFS (A, B, C, D, E): completion times are 6, 8, 16, 19 and 28. Tardiness: A is 0, B is 8−6=2, C is 0, D is 19−15=4, E is 28−23=5.
Average flow time =56+8+16+19+28=577=15.4 days
Average tardiness =50+2+0+4+5=511=2.2 days; 3 jobs late
Average jobs in system =2877=2.75
SPT (B, D, A, C, E): completion times are 2, 5, 11, 19 and 28. Tardiness: B 0, D 0, A 11−8=3, C 19−18=1, E 28−23=5.
Average flow time =52+5+11+19+28=565=13.0 days
Average tardiness =59=1.8 days; 3 jobs late
Average jobs in system =2865=2.32
EDD (B, A, D, C, E): completion times are 2, 8, 11, 19 and 28. Tardiness: B 0, A 0, D 0, C 1, E 5.
Average flow time =52+8+11+19+28=568=13.6 days
Average tardiness =56=1.2 days; 2 jobs late
Average jobs in system =2868=2.43
Rule
Sequence
Average flow time (days)
Average tardiness (days)
Late jobs
FCFS
A-B-C-D-E
15.4
2.2
3
SPT
B-D-A-C-E
13.0
1.8
3
EDD
B-A-D-C-E
13.6
1.2
2
SPT gives the lowest average flow time, while EDD gives the lowest tardiness and the fewest late jobs. FCFS is worst on both measures here. The choice of rule depends on what the shop values most.

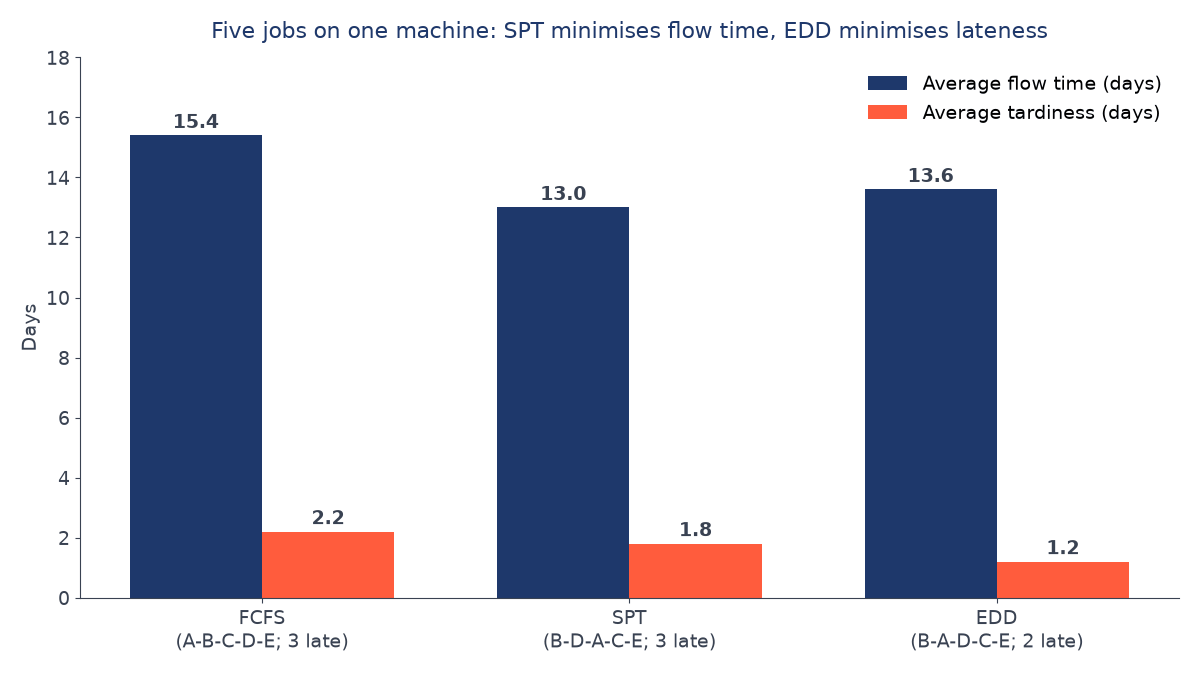

Results of the five-job example. SPT minimises flow time; EDD minimises lateness.
When every job must pass through two machines in the same order, Johnson's rule gives the sequence that minimises makespan, the total time to finish all jobs. The steps are:
List the time of each job on both machines.
Find the shortest time remaining in the list.
If it is on Machine 1, place that job as early as possible; if it is on Machine 2, place it as late as possible.
Remove the job and repeat until all jobs are placed. Break ties arbitrarily.
A Gantt chart is a bar chart with time on the horizontal axis and machines, workers or jobs on the vertical axis. Each bar shows when an activity starts and finishes. It is easy to understand, shows progress clearly, helps compare planned with actual work and is widely used for machine and labour scheduling. Two common forms are the load chart, which shows how busy each work centre is, and the schedule chart, which tracks each job against time.

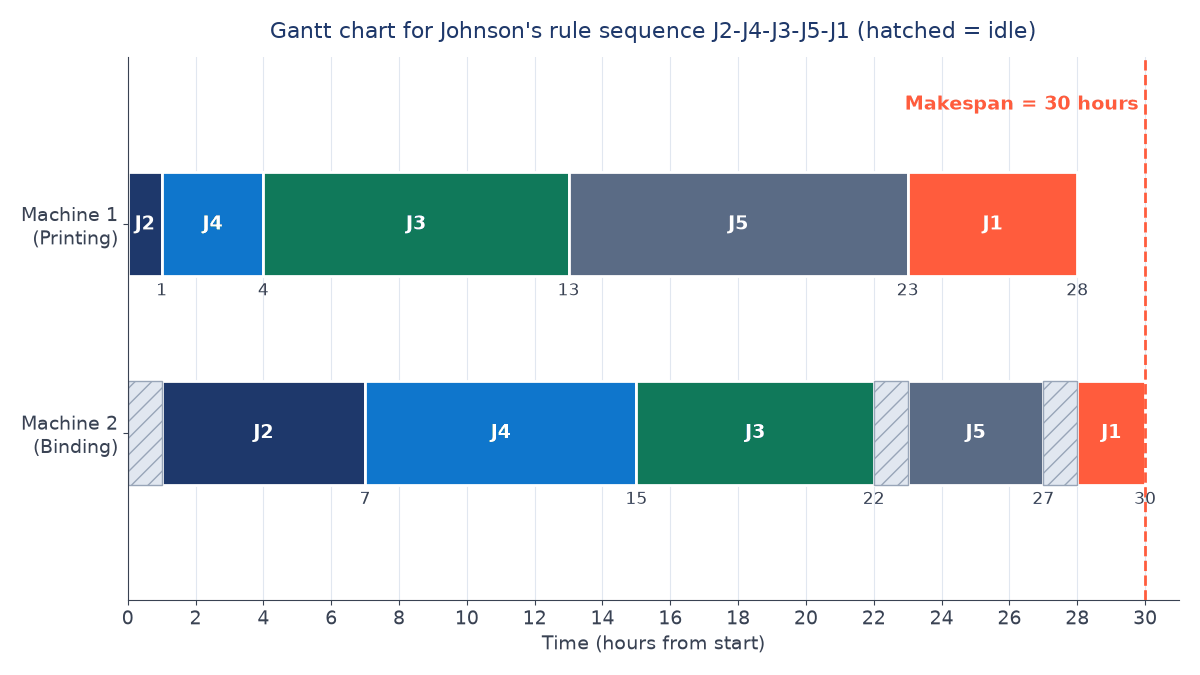

Gantt chart for the Johnson's rule example. Hatched blocks show idle time on the binding machine.
Scheduling raises productivity by reducing idle time, improving machine use, reducing waiting and avoiding congestion. When jobs start and finish at the right time, output rises without adding resources.
A poor schedule leads to missed deadlines, idle machines alongside overloaded ones, high work-in-progress, overtime and frustrated staff. Even a good schedule can be upset by rush orders, machine breakdowns, power failures, worker absence, material shortages, quality rejections and transport delays. Schedules must therefore be flexible and reviewed often; a rigid schedule fails when conditions change.
No single rule is best for every measure. SPT always minimises average flow time on a single machine, while EDD minimises the maximum lateness. Managers choose according to their main objective.
When a set of jobs must pass through two machines or work centres in the same order and the aim is to minimise the total completion time.
How is forward scheduling different from backward scheduling?#
Forward scheduling starts from today and finds the earliest finish; backward scheduling starts from the due date and finds the latest start. Backward scheduling keeps inventory lower but leaves less slack.
What is the difference between scheduling and dispatching?#
Scheduling prepares the time plan, for example Job A starts at 10 AM. Dispatching tells the worker or department to begin Job A at 10 AM.
Johnson, S. M. (1954) "Optimal two- and three-stage production schedules with setup times included". Naval Research Logistics Quarterly, 1(1), 61–68.
Stevenson, W. J. Operations Management. McGraw-Hill Education.
Heizer, J., Render, B. and Munson, C. Operations Management: Sustainability and Supply Chain Management. Pearson.
Chary, S. N. Production and Operations Management. McGraw-Hill Education (India).
Panneerselvam, R. Production and Operations Management. PHI Learning.
